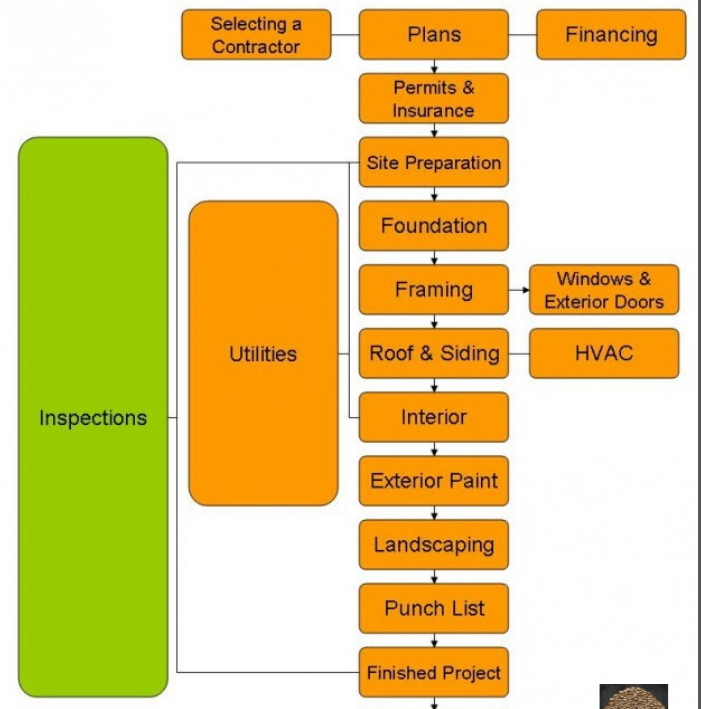

House construction process from bottom to top
Following are the Steps Involved in Building Construction Process from Start to Finish Pdf:
I) Pre-Construction Steps
- To Acquire Land or Plot.
- To Seek Technical Help.
- Prepare Estimation and Budgets.
- Permission from Authorities.
- Approach a Builder.
- Superstructure – Column.
II) During Building Construction Steps
- Site Preparation or Levelling work.
- Excavation and PPC.
- Foundation.
- Plinth Beam or Slab.
- Superstructure – Column
- Brick Masonry Work.
- The Lintel Over Door Window Gaps.
- Floor Slab or Roof Structure.
- Door Window Framing and Fixations.
- Electrical and Plumbing.
- Exterior Finishing.
- Terrace and Roof Finishing.
- Internal Finishes.
- Woodwork and Fixture Fittings.
Steps of House Construction Activity in India
- Purchasing of Site
- Document verification
- Building Design - House plan, structure details, estimation of the building and front elevation design
- Government Approval
- Site Leveling
- Bore well
- Consult Contractors
- Building Construction contractor
- Earthwork contractor
- Wooden carpentry work contractor
- Electrical contractor
- Plumbing contractor
- Tails fixing contractor
- Granite laying contractor
- Painting contractor
- Gas pipeline laying contractor
- Temporary Shed construction
- Site marking
- Earthwork
- Site leveling
- Foundation, sump, and pillars area digging
- Sump construction
- Drinking water sump
- Rainwater harvesting sump
- A Temporary power supply arrangement
- Bar bending work
- Water curing
- Foundation construction
- Piller footing
- Filling cement concrete up to plinth level
- Stone foundation as per design
- Plinth beam
- Red soil filling to plinth area
- Piller raising to 7 feet
- All Doors frame fixing and leveling
- Wall construction up to 3 feet
- Window frame fixing
- Setup lintel and sajja to window and door level
- Raise pillers 10 feet above the plinth level
- Raise walls 10 feet above the plinth level
- Centering for beam and also roof
- Consult for an electrical contractor for provision of roof pipes
- Fix centering plates on the water level
- Cover all the gaps between the plates
- Apply oil to the plates and spread mat over the area
- Bar bending work for beams and roofs
- Electrical pipes run inside the roofs and beams before molding
- Molding and Steps construction
- After 12 Hours of molding
- After 21 days, remove centering materials
- Construct safety grill/Safety Rcc wall around the terrace
- Check electric pipes blockage in the RCC
- Electrical, Dish line, and Internet marking
- Incommer supply box fixing
- Electrical pipeline laying inside the house
- Plumbing work for the kitchen, bathroom, and wherever required
- Laying of water pipes and sewage pipes till the outside wall
- Setup Western/Indian toilet to the bathroom
- Close all water pipes and sewage pipes with end caps inside and outside
- Gas pipeline laying inside and outside wall
- Fix kitchen Platform, sink, and Shelves in the kitchen room
- Start inside wall and roof plastering
- Wherever tails fixing Inside or Outside walls, provide rough plastering
- Painting
- Birla white cement as to plaster for smooth finishing – 2 coats
- One coat of primer paint inside the wall
- Final coat painting
- Wall tails fixing
- Floor tails or Granite laying
- Outside wall plastering
- Outside plumbing work and tank fixing
- Outside one coat primer and one coat painting
- Inside and Outside plumbing material fixing
- Electrical switch box cover fixing and wiring
- Electrical accessories fixing inside the building
- Laying of an electrical service line for Permanent connection
- Digging of Electrical Earthing Pit
- Digging of Toilet/Septic Pit
- Swege line connection to drainage
- Parking tails fixing
- Compound wall construction around the building
- Main gate
- Front elevation
Above is all the house construction activity we did while constructing our house. There could be a few extra or fewer steps involved depending on your requirements.
